Learn how Univers helped a leading Norwegian renewable energy IPP bring 1.1 GW of solar and 100MW/200MWh of battery storage online near Luxor — passing grid-connection in a single day, ten days ahead of schedule.
Egypt’s energy transition has accelerated rapidly — and with it, the regulatory and technical bar for utility-scale renewables. Hybrid solar-plus-storage assets at gigawatt scale bring complexity that grid-only or storage-only projects don’t face: two different OEM stacks, two different control philosophies, and one grid code that treats the asset as a single, dispatchable entity.
Located near Luxor, the project is the first large utility-scale hybrid renewable project in Egypt — combining 1.1 GW of Sungrow solar with 100MW/200MWh of Envision Energy battery storage on a single site. The client needed a control and monitoring platform that could unify both OEM stacks, meet the Egyptian Grid Code on a compressed timeline, and stay future-ready as the regulator continues to refine utility-scale BESS requirements.
Univers was selected to deliver the full intelligence layer: Hybrid Power Plant Controller, Hybrid SCADA, dedicated PV and BESS SCADA, and the EMS that sits across them.
The hardware itself wasn’t the problem. Making two different OEM stacks behave as one grid-compliant hybrid asset — on an accelerated schedule, against still-evolving regulations — was.

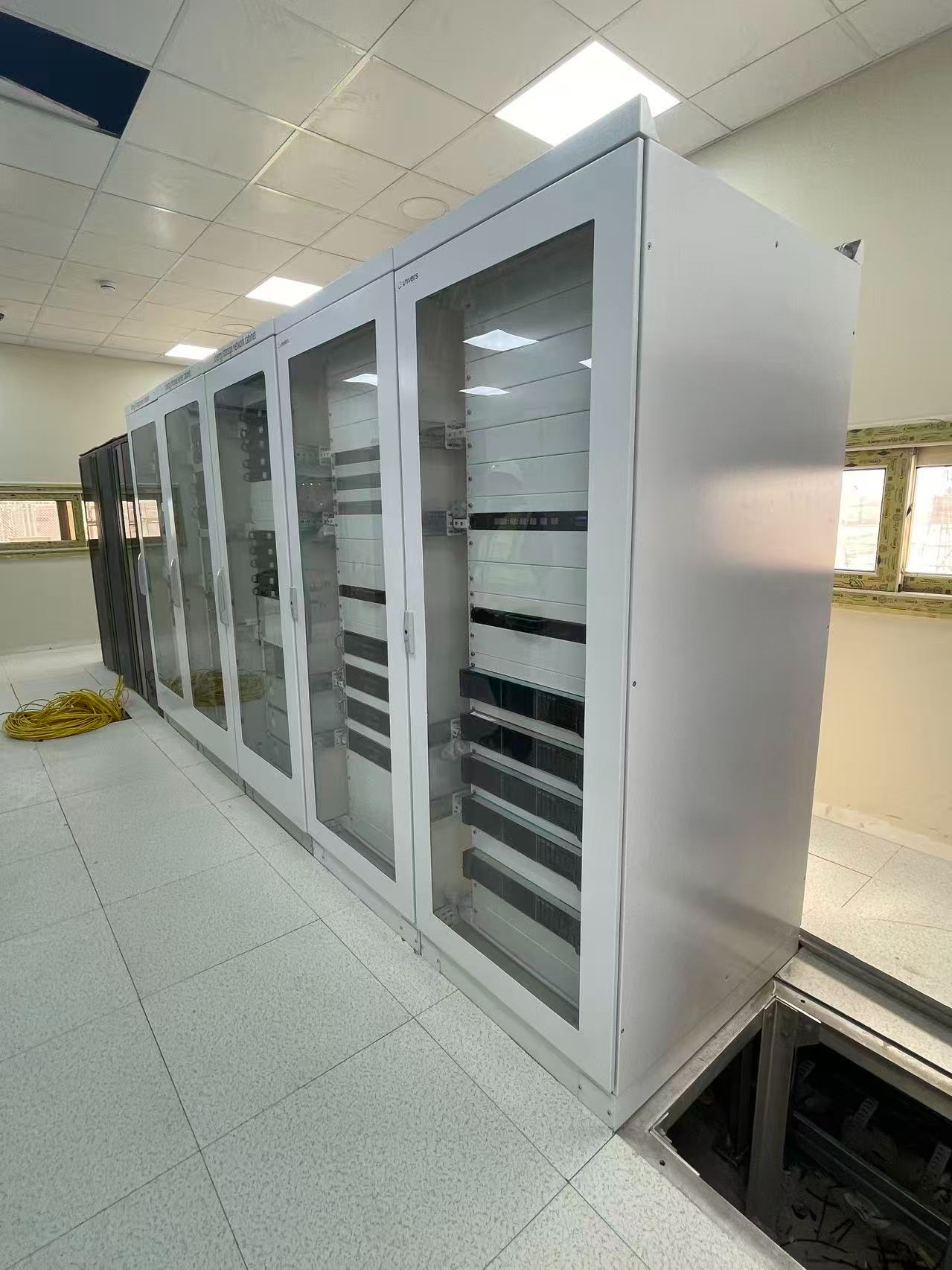

Univers deployed a unified hybrid control and monitoring stack across the site, sitting above both OEM systems and presenting the asset to the grid as a single, intelligent entity.
Phase 1 is in stable commercial operation. Phase 2 is in progress. The headline outcome from the commissioning cycle was a clean grid-connection result under an accelerated timeline.
Despite the testing window being compressed by ten days, the asset passed Egyptian grid-connection testing on the first day of the test cycle. Every grid-code requirement met on the first attempt.
Phase 1 is running stably under HPPC control — solar and storage coordinated as a single hybrid plant, with third-party forecasting feeding dispatch decisions in real time.
The project is now established as a benchmark for utility-scale hybrid projects in Egypt and the wider region — proof that gigawatt-scale, multi-OEM hybrid assets can be commissioned on time, grid compliant, and commercially active.
Hybrid renewables are where the next wave of utility-scale capacity is going — and the integration challenge sits at the centre of every one of those projects. The IPP’s Egypt deployment shows that with a hardware-agnostic control layer and disciplined commissioning, multi-OEM hybrid assets can be brought online faster than the schedule asks for, fully grid compliant, and ready for whatever the regulator releases next.
Scatec chose Univers for a proven hybrid track record, hardware-agnostic integration, deep grid commissioning expertise, a scalable optimisation platform, and trading-ready capabilities. This project is now part of the reference set we’ll be building on across the region.
